Construction Estimate Template Excel for Hardscapers

Senior Writer · · 9 min read
Cover illustration for “Construction Estimate Template Excel for Hardscapers”
Quoting and Estimating · August 2, 2026 · 9 min read · 2,101 words

Hardscape pricing resists generalization more than almost any other trade, and if you don't understand why, any template you build will be wrong before the first estimate leaves your desk.

Installed costs for a standard paver patio run roughly $12 to $25 per square foot. Flagstone pushes that to $18 to $35. Retaining walls land somewhere between $20 and $50. Outdoor kitchens blow past $300 per square foot once amenities stack up. Those ranges sound useful until you actually try to apply them to a real job on a real street.

The same 400 square foot paver patio costs roughly $5,500 to install in Mississippi and $11,400 in coastal California. Same material category, same labor classification, completely different market. Any template carrying national averages as fixed defaults will be systematically off for whoever opens it. Unit costs need to be regional inputs you control, not figures hardcoded from an article someone read two years ago.

Labor compounds the variance further. Billable crew rates run $50 to $120 per hour nationally. That upper number matters: it's a loaded rate that already accounts for overhead, equipment, insurance, and payroll taxes. A contractor pricing on bare wage figures is telling himself a story that feels conservative and costs him money on every single job.

Then site conditions enter. Tight lot access, clay soils that need extra excavation, long wheelbarrow hauls on a hillside property, complex curves or premium patterns that demand precise cuts: each of these pushes labor toward the top of any range, sometimes past it. The template's job is to surface these variables every time, because if you leave them to estimator intuition, intuition will eventually be wrong on the job you can least afford.

The sections every hardscape estimate template needs

A complete hardscape estimate template is not a price list with a total at the bottom. It's a structured document that forces you to account for every cost category before you commit to a number.

Required sections: client information and project address; a scope description that states explicitly what is included and what is not; site preparation covering grading, excavation, drainage, and access; a materials section with quantity, unit, and unit price columns; a labor section with hours, crew size, and rate columns; equipment and rental costs as a distinct line; overhead allocation; a contingency line; markup and margin calculations; tax fields; payment terms; and a signature block with an estimate validity date.

Pre-built line items for common job types, standard paver patios, walkways, retaining walls, driveways, outdoor kitchens, reduce the probability of a missed cost category on a job type you haven't priced recently. It's a quality control mechanism that catches the omission before the contract is signed rather than after the base course is down.

One line item worth building in from the start: a design fee, typically $250 to $500, credited toward the project at hire. It filters uncommitted leads and protects estimator time on inquiries that were never going anywhere. Beyond that, the structural principle is simple: the estimator inputs quantities and pulls current supplier prices. Every calculation from there belongs to the template.

How to build the materials section so it calculates correctly

The materials section fails in predictable ways. Missing waste factors, hardcoded unit costs that went stale six months ago, line items grouped so loosely that an entire category disappears. None of these are mysterious. They're solvable.

Column structure for each material line: description, unit of measure (square foot, linear foot, ton, each), quantity, unit cost, extended cost calculated automatically. Group materials by phase, not by the order they occurred to you: base materials like gravel, sand, and aggregate; surface materials including pavers, flagstone, or concrete; wall materials; drainage components; lighting; accessories. Grouping by phase makes omissions visible and makes the estimate readable when you come back to it two days later with fresh eyes.

Unit cost should never be hardcoded inside the estimate itself. It should reference a separate price list tab that gets updated on a regular cadence, quarterly at minimum, more often when material markets are moving. Supplier costs shift seasonally, sometimes mid-season on aggregates and concrete. Pricing a late-summer job off numbers you pulled in April doesn't look like a problem until the margin reconciliation after close, and by then the money is already spent.

Add a waste factor multiplier column. A standard 5 to 10% on pavers accounts for cuts and breakage; irregular patterns or natural stone require more. Without that multiplier, you're consistently quoting material quantities that won't finish the job. The result is a mid-project reorder at retail pricing, an awkward conversation with the homeowner, and margin that's gone before the final course is set.

Building the labor estimate so it reflects how hardscape work actually runs

A single "labor" line with a round-number total is not a labor estimate. It's a guess with formatting. Hardscape labor should break down to the task level because different phases carry different crew compositions and genuinely different time requirements.

Column structure: task description, crew size, estimated hours, crew hourly rate, extended labor cost. Distinct rows for, at minimum: excavation and demolition, base preparation and compaction, material delivery and staging, paver or stone installation, wall construction if applicable, drainage installation, final cleanup and grading.

The crew hourly rate must be the loaded rate. Wages, payroll taxes, workers' compensation, general liability, equipment depreciation, overhead allocation. All of it. A template built on bare wages produces estimates that look competitive and perform terribly. You find out at close, never before.

Build a complexity multiplier in as a user-controlled input. A baseline of 1.0 applies to a standard flat patio with good access. Curves, steps, or premium patterns add 10 to 20%. Difficult access, tight lots, long haul distances, hillside conditions add 15 to 25%. Clay soils needing additional excavation add roughly 10%. The multiplier applies to the labor total before markup, which is where it belongs.

A tab within the template that records actual hours by task type on completed projects becomes, over time, a proprietary benchmark no industry average can replicate. A hillside retaining wall with integrated stone steps is a materially different labor equation than a flat suburban patio. The only way to price that difference with any confidence is to have logged what it actually took the last time you built one.

Markup, margin, and contingency (the calculations most templates get wrong)

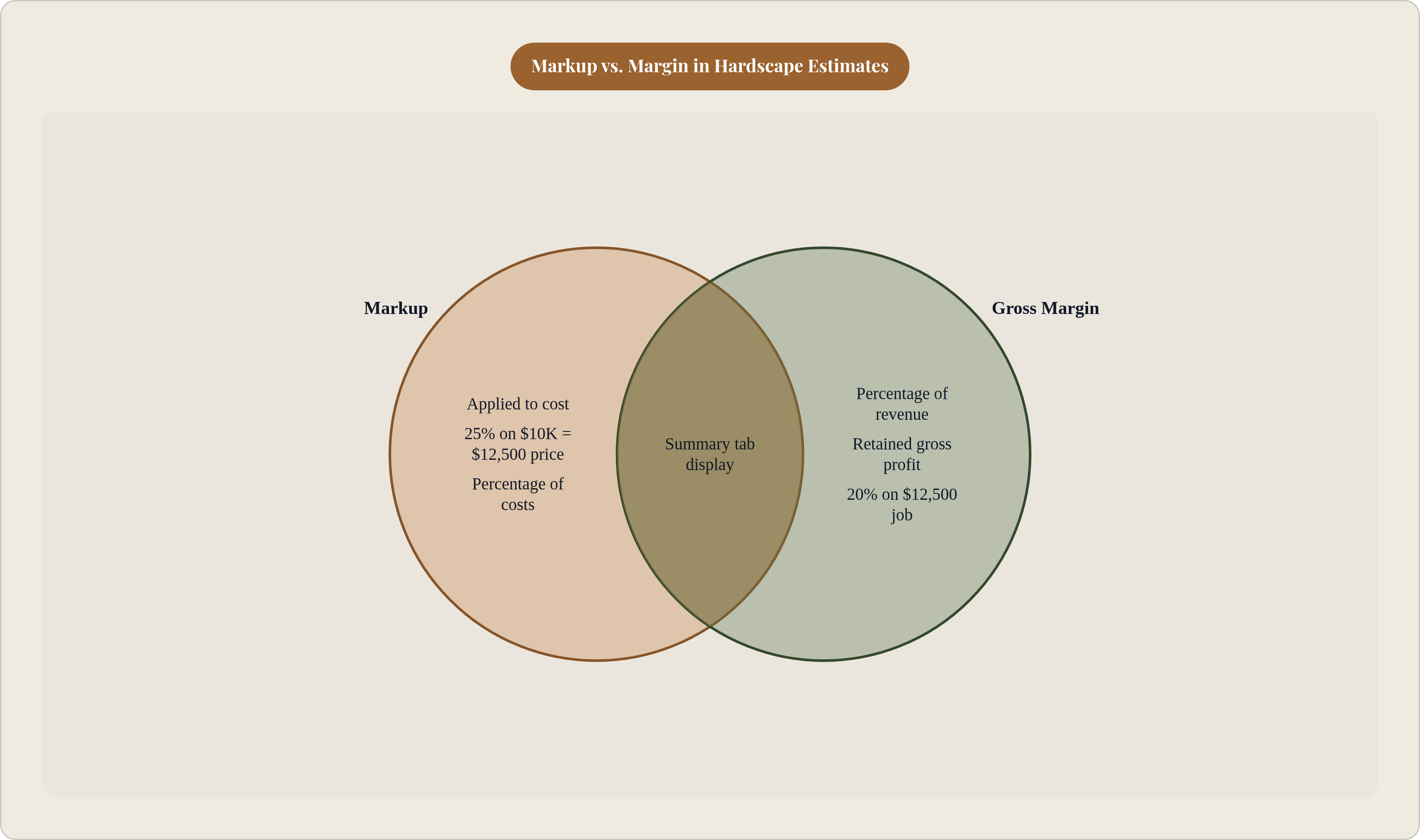

Venn diagram: Markup vs. Margin in Hardscape Estimates. Compares Markup and Gross Margin; overlap: Both Track.

This is where the arithmetic looks correct and the business logic fails quietly.

Markup and margin are not synonyms, and treating them as such costs money on every job. Markup is a percentage applied to cost. Margin is the percentage of revenue retained as gross profit. A 25% markup on $10,000 in direct costs produces a $12,500 price, but only a 20% gross margin. A contractor who believes they're running at 25% margin when they're actually at 20% carries that discrepancy across every job in the portfolio. The template should display both figures so the estimator knows what they're actually keeping, not what they assume they're keeping.

Contingency belongs above the markup line. Contingency (typically 10 to 15% of direct costs) is a cost buffer for the things you didn't see coming: a drainage complication, a utility line in the wrong place, material price variance between quote and delivery. It is not profit. Applying contingency after markup mathematically understates project risk and produces a situation where actual costs exceed the reserve, cutting into markup that was already thin.

The formula chain for the summary tab should be explicit and visible to the estimator, though hidden from the client view. Direct costs equal materials plus labor plus equipment. Contingency equals direct costs multiplied by your contingency rate. Overhead equals direct costs multiplied by your overhead rate. Subtotal equals the sum of those three. Markup equals subtotal multiplied by your markup rate. Total price equals subtotal plus markup. Gross margin displays as markup divided by total price.

On overhead allocation: some contractors fold it into the loaded crew rate; others apply it as a separate line percentage on the summary tab. Either works. What doesn't work is doing both, which double-counts overhead and inflates price, or doing neither, which means overhead gets absorbed into margin that was never meant to carry it.

Tax fields should be additive after the total price, never blended into markup. Blending creates an estimate that is neither legally transparent nor easily auditable. If your jurisdiction requires sales tax on materials, the tax line shows the rate applied to the applicable subtotal, separate and legible.

Formatting the estimate so clients sign it, not file it

The estimate the client sees should not be the working spreadsheet. It should be a clean document that communicates confidence without exposing your internal pricing architecture.

In Excel, accomplish this with a dedicated client view sheet that pulls from the working sheet through cell references but presents only line items, quantities, and totals. Unit costs and markup percentages stay on the working sheet. The client view prices the project credibly without handing someone a map they'll use to compare your labor rate line by line against a competitor's.

A brief scope narrative at the top of the client document matters more than most estimators acknowledge. It should describe what work is covered, what site conditions the estimate assumes, and what is explicitly excluded. Scope creep disputes almost always trace back to an estimate that was vague about where the job ended. A few clear sentences at the top resolves this before the first shovel goes in the ground.

Payment terms should appear as a named section, not fine print. A standard structure of 30 to 50% deposit, a midpoint progress payment, and balance on completion is straightforward for the client to plan around. An estimate validity date of 30 days is standard; it reflects legitimate cost volatility and signals that your capacity is real and finite.

Include your license number and insurance statement in the header. These are the signals homeowners actually use when comparing bids, and a contractor who omits them concedes ground to one who doesn't.

Send the client-facing version as a PDF. A live spreadsheet file exposes your formulas, creates formatting risk across devices, and reads as unfinished. A PDF signals that the estimate is a deliverable.

Turning estimate speed into a competitive advantage

A homeowner who receives a detailed, itemized, clearly formatted estimate within 24 hours of a site visit will often conclude that if the estimating process is this organized, the installation will be too. That conclusion shifts the comparison away from price, and price is a much harder place to win.

The mechanics are straightforward. A template with pre-built line items for common job types removes the cold-start problem on every new estimate. You walk the site, take measurements, note the conditions that will complicate the work, and return to a structured document that already knows what questions to ask. Input quantities, pull current supplier pricing from the price list tab, adjust the complexity multiplier, and the math resolves.

The time savings compound. Cutting estimate preparation from three hours to 45 minutes means a two-estimator operation can respond to substantially more inquiry volume without adding headcount. In a market where homeowners contact multiple contractors simultaneously, the ability to quote more jobs at higher speed without sacrificing accuracy is a real operational edge.

Where a spreadsheet template ends and a scalable system begins

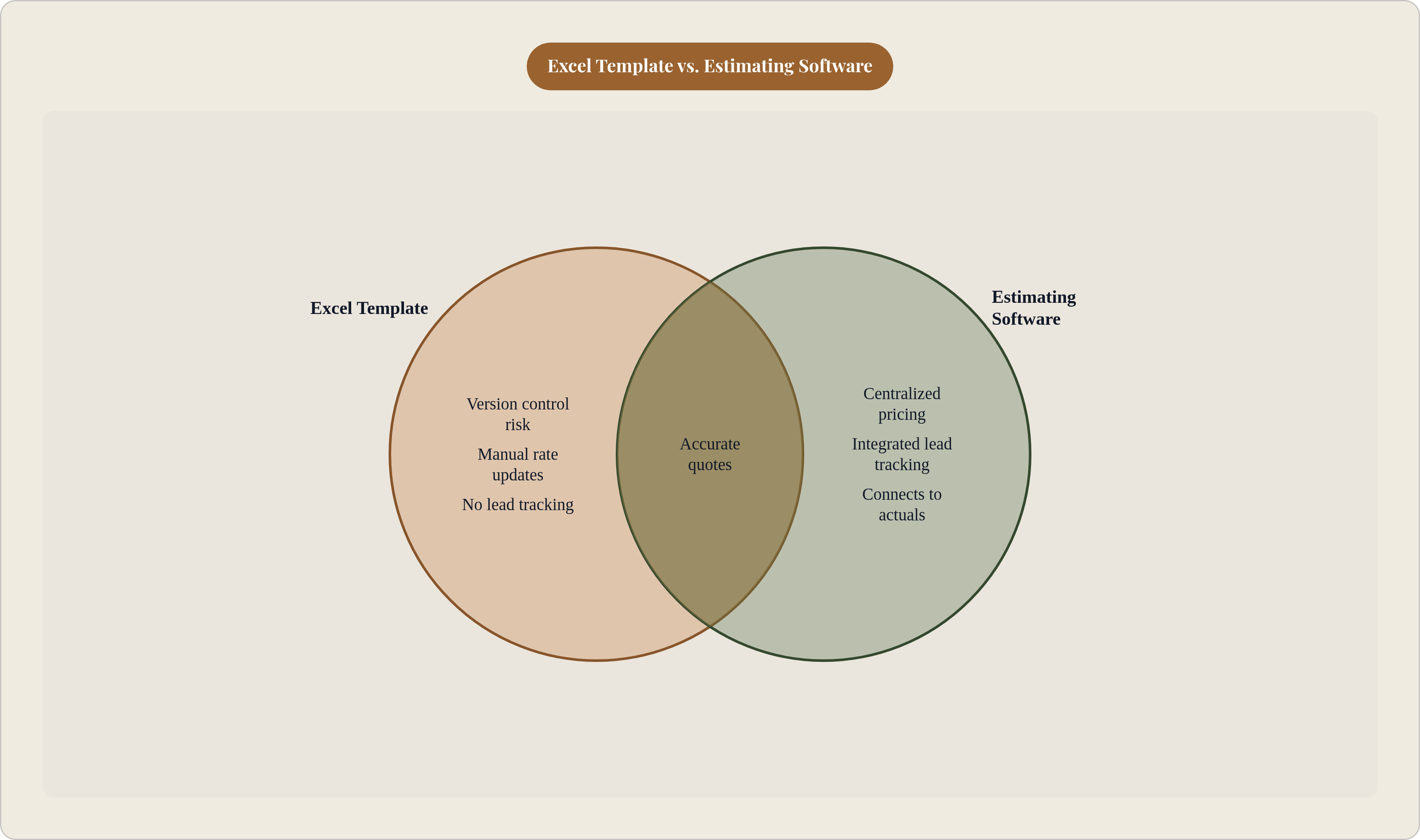

An Excel template is the right starting point for a solo operator or small crew quoting manageable residential volume. It costs nothing beyond time, requires no integration, and can be operational today. Reaching for software before the business justifies it is a common and expensive mistake.

The limits show up less gradually than you'd expect. Multiple estimators working from different saved versions produce inconsistent pricing. There's no audit trail of which estimates went out, when, or how the client responded. The estimate lives in isolation from the CRM, the job calendar, and the invoice workflow, so information gets re-entered by hand at every handoff. And under workload pressure, the price list tab stops getting updated, quietly eroding margin on every job that follows.

The transition point is recognizable when it arrives: estimate volume becomes unmanageable, pricing inconsistency becomes a recurring conversation, or the follow-up process breaks down because nothing connects to anything else. That's when the spreadsheet has done its job. It has taught the business what the work actually costs, what margin it needs to sustain, and what a consistent quoting process looks like in practice. Building on that foundation is what makes moving to a more integrated system worth doing.
